Hydraulic piston motors: installation and commissioning

Prepare a hydraulic piston motor for service: check case filling, drain routing, oil cleanliness, shaft loading and the first commissioning procedure.

Preparation before installing the motor

Installing a hydraulic piston motor requires checks of the circuit, mechanical coupling and instructions for the exact model. These general points do not replace the manufacturer's manual. Qualified personnel should secure the machine and isolate its energy sources before disconnecting components.

Preparation before installing the motor

Confirm the complete part number, displacement, mounting, shaft, operating direction and identification of every port. A visually similar unit may require a different drain arrangement, fluid or permissible case-pressure limit.

Oil and circuit cleanliness

The hydraulic fluid must suit both the motor and the other system components. Before installation, remove contamination from the pipework and inspect the inside of the reservoir. Check fittings, seals and hoses: defective connections may leak or allow air into the circuit.

Oil and circuit cleanliness

Replace filters where required and use clean oil meeting the specified filtration requirement. Cleaning is especially important after an internal failure of the previous motor. Installing a replacement without removing debris from the circuit can damage the new unit.

Oil and circuit cleanliness

Case filling and the drain connection

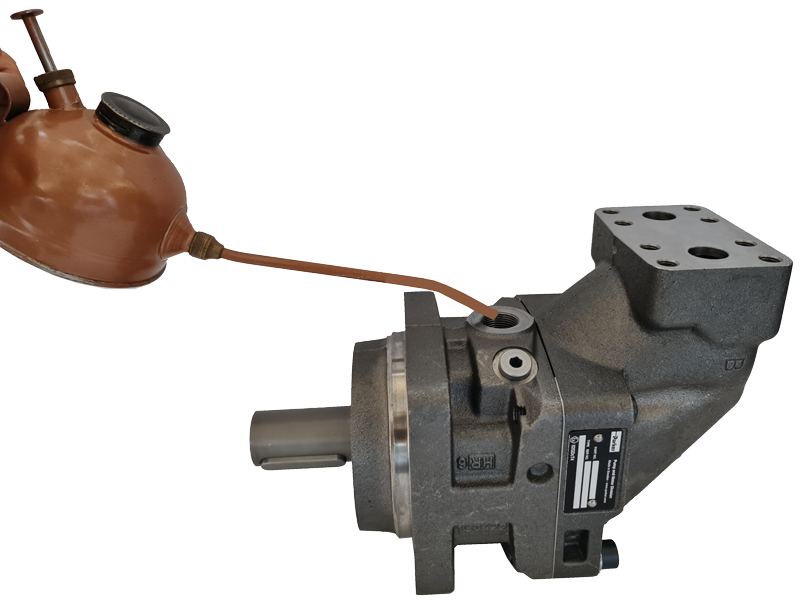

Do not start the motor with an empty case when pre-filling is required. In the illustrated arrangement, the case is filled through the upper drain connection and the designated inlet and outlet ports. Confirm the exact filling method, fluid and bleeding procedure in the model-specific manual.

Case filling and the drain connection

The reference instructions use the upper drain port and route the line directly to the reservoir, discharging below the oil level. Verify that this arrangement is approved for the chosen mounting position. Keep the drain line unrestricted and comply with the manufacturer's case-backpressure limit.

Coupling, pipework and shaft loads

  • Align the drive and use the coupling specified for the application.
  • Ensure axial and radial shaft loads stay within the motor's limits; do not assume every motor can directly support the driven load.
  • Size hoses, pipes and fittings for maximum flow, avoiding tight bends, restrictions and tension in the hoses.
  • Allow suitable flexibility to limit transmitted vibration while properly supporting the lines.

Progressive start-up and checks

Bleed the system using the approved procedure. With the load secured and protective devices set as required for the machine, begin at low speed and the lowest pressure permitted by the commissioning instructions. Maintain this condition for the prescribed time, then increase speed and pressure progressively towards the service values.

Watch for leaks, unusual noise, vibration, temperature rise and bubbles in the reservoir. Recheck the drain and connections. If an abnormal condition appears, stop commissioning and find the cause before proceeding. Final settings and any warranty-related installation requirements must follow the manufacturer's documentation.
